Measures of Risk and Uncertainty

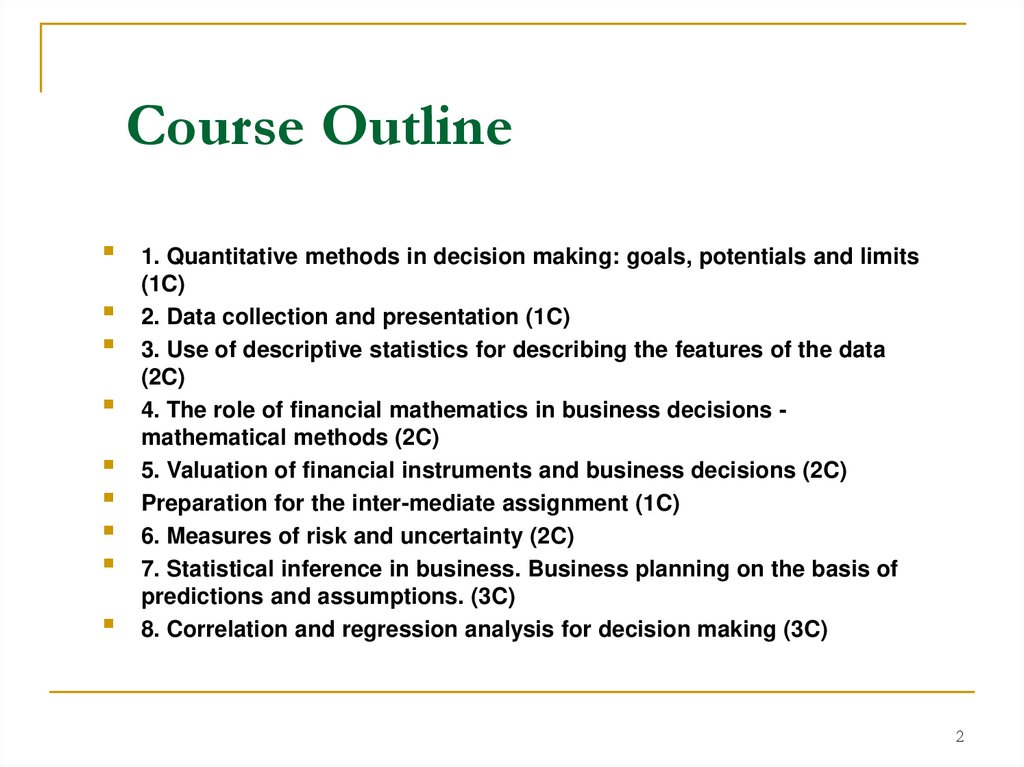

Course Outline

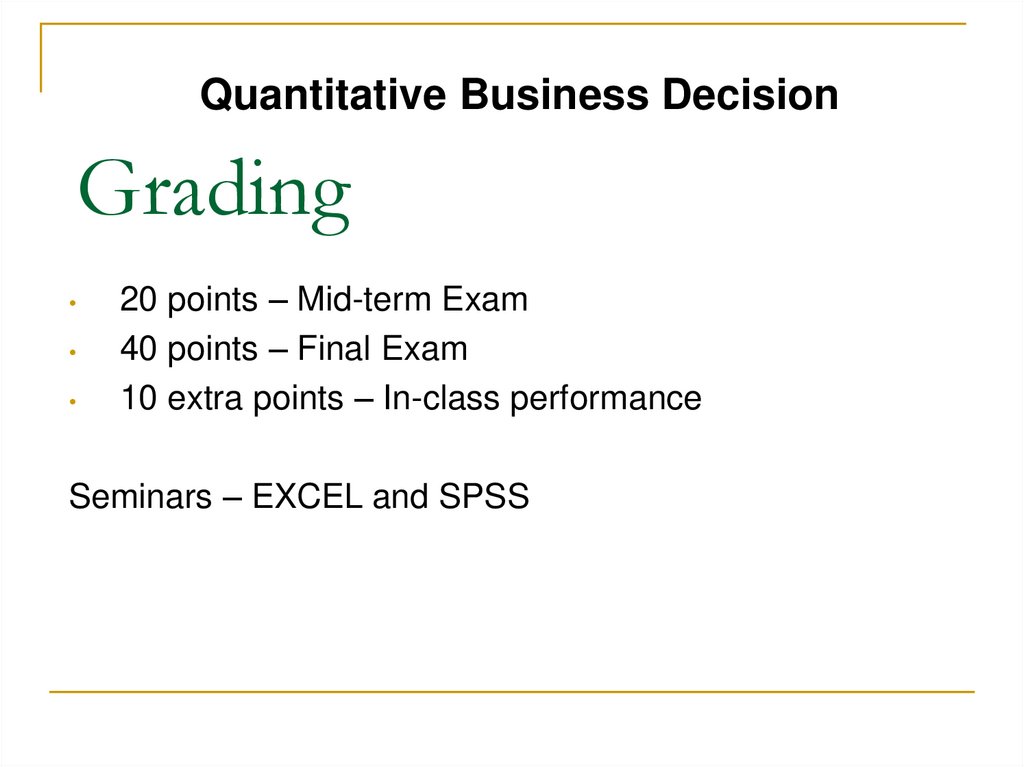

Grading
2-stock Portfolio
I. Minimum risk for a fixed return

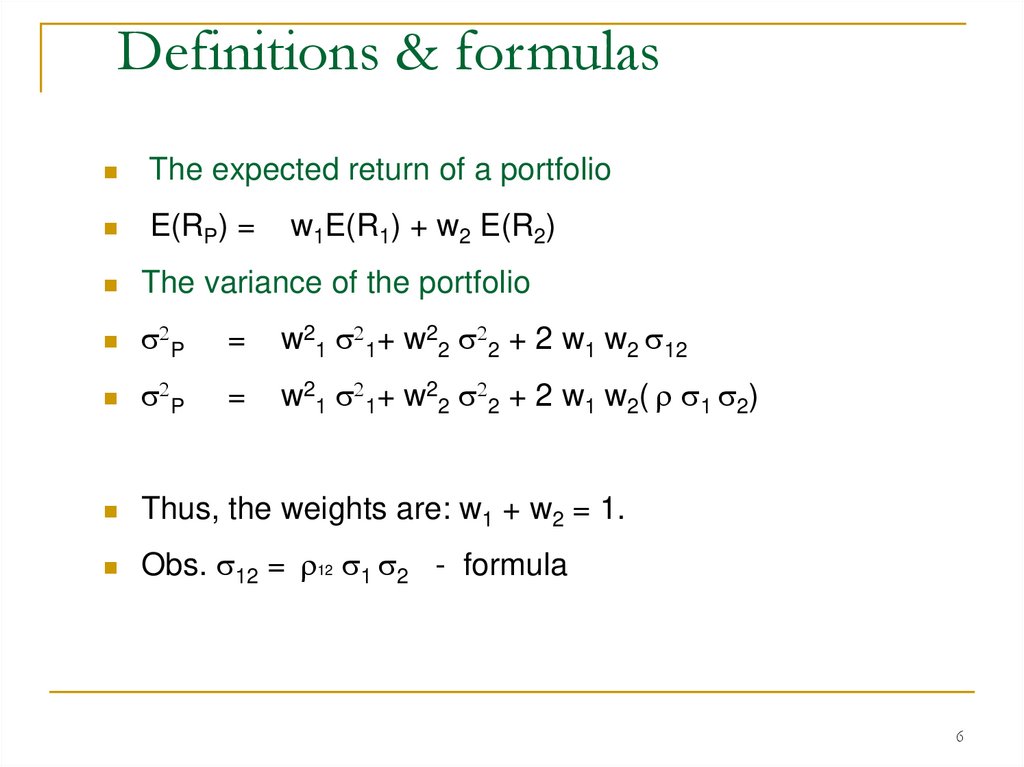

Definitions & formulas

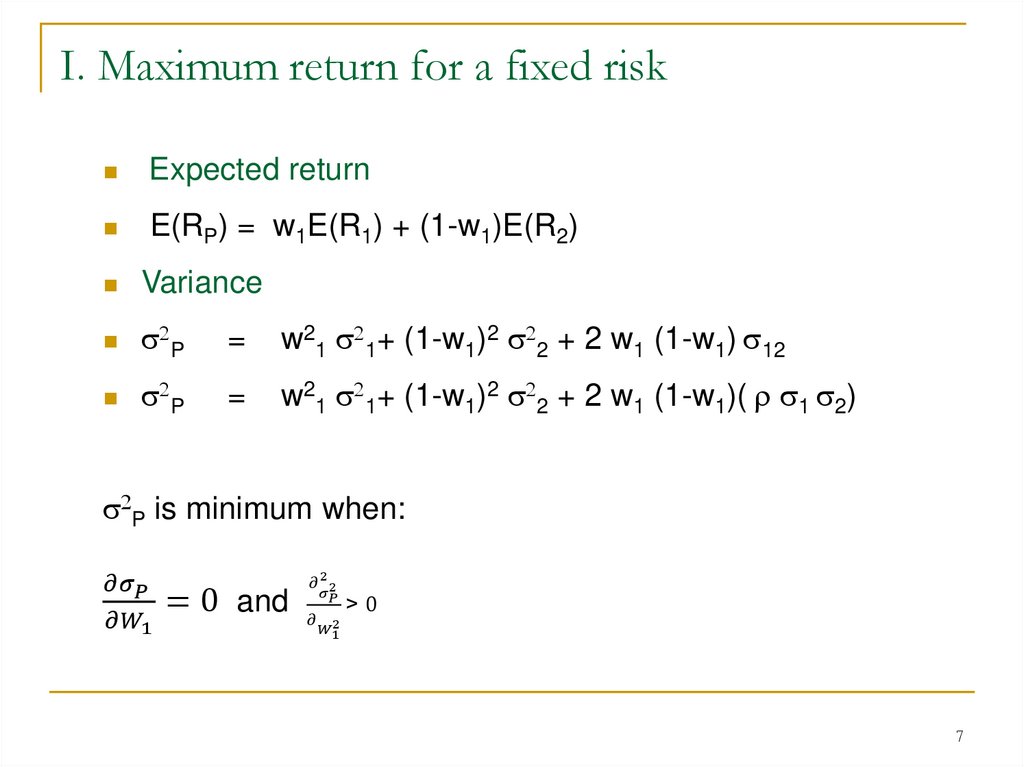

I. Maximum return for a fixed risk

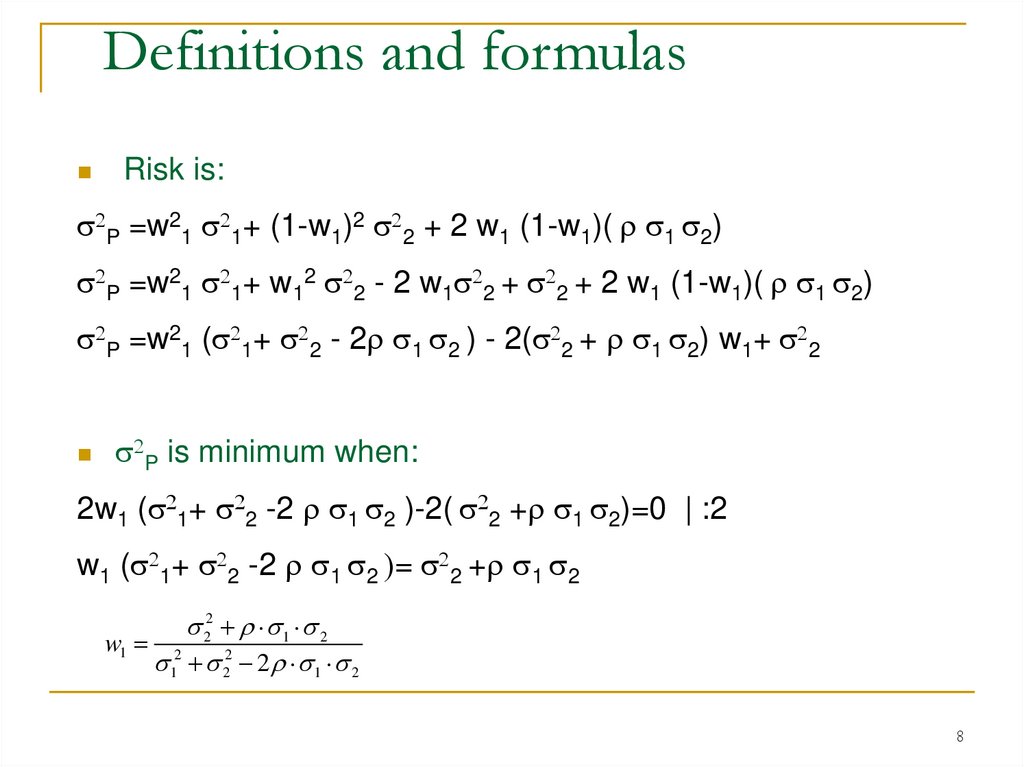

Definitions and formulas

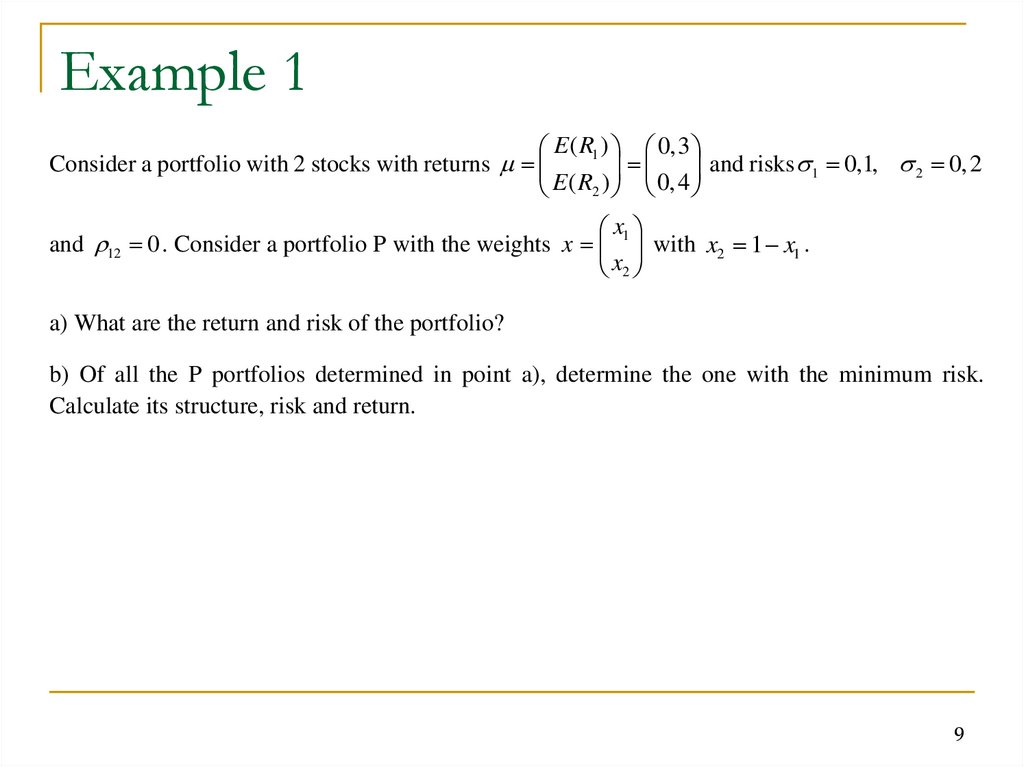

Example 1

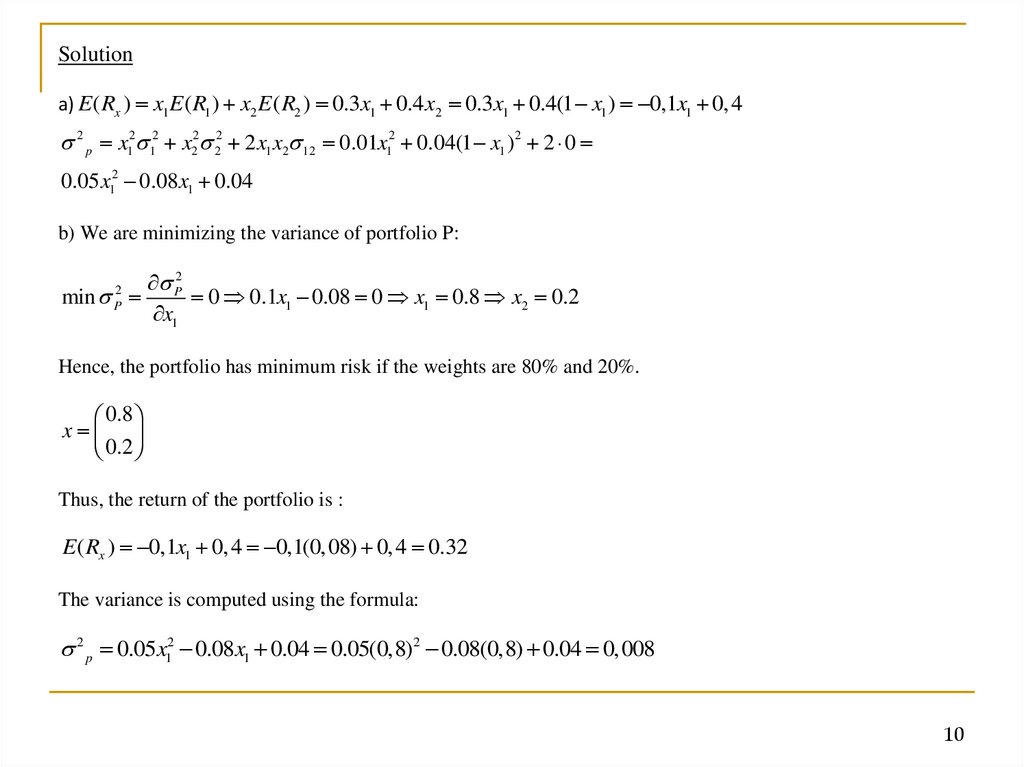

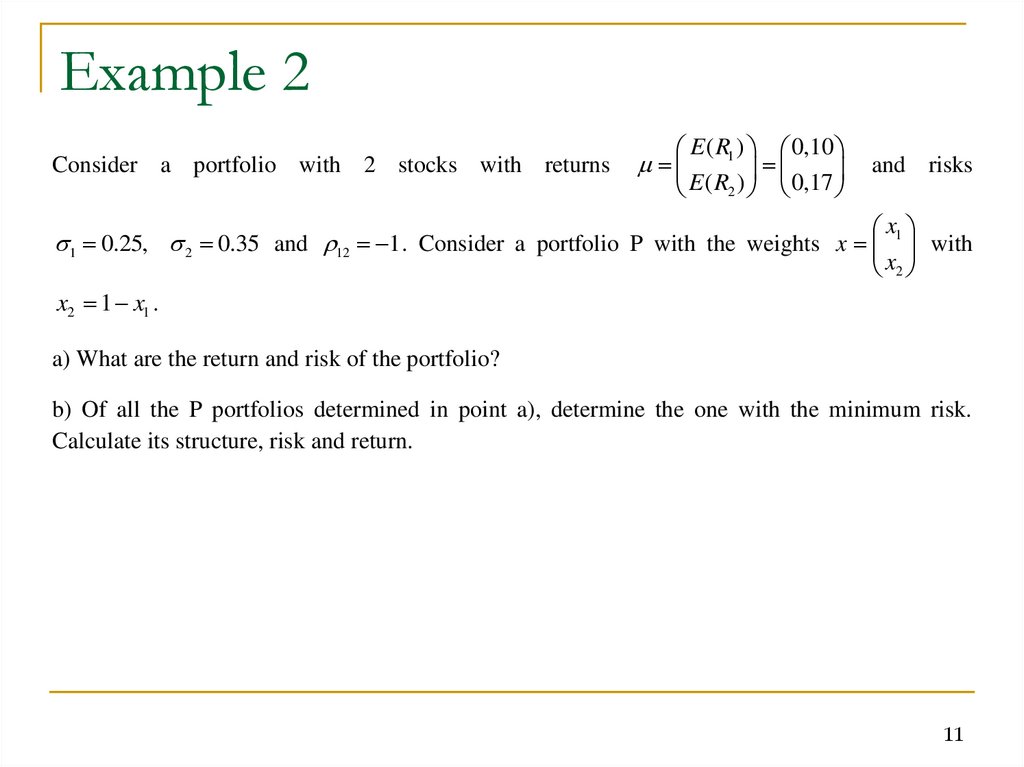

Example 2

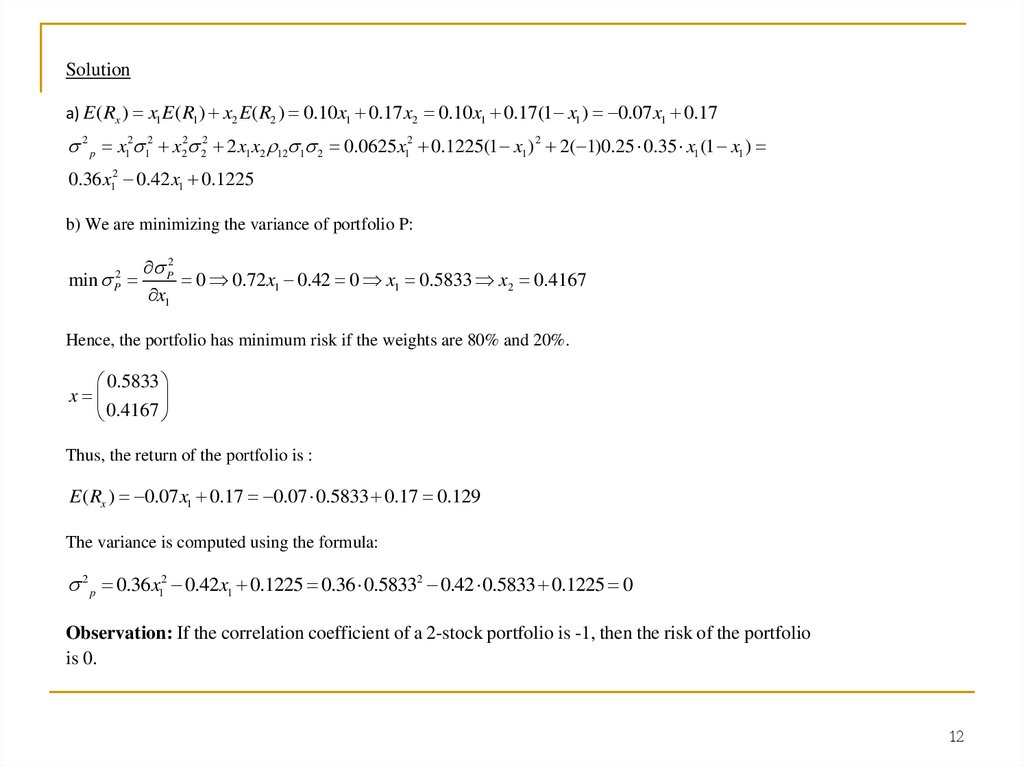

Solve the following problems

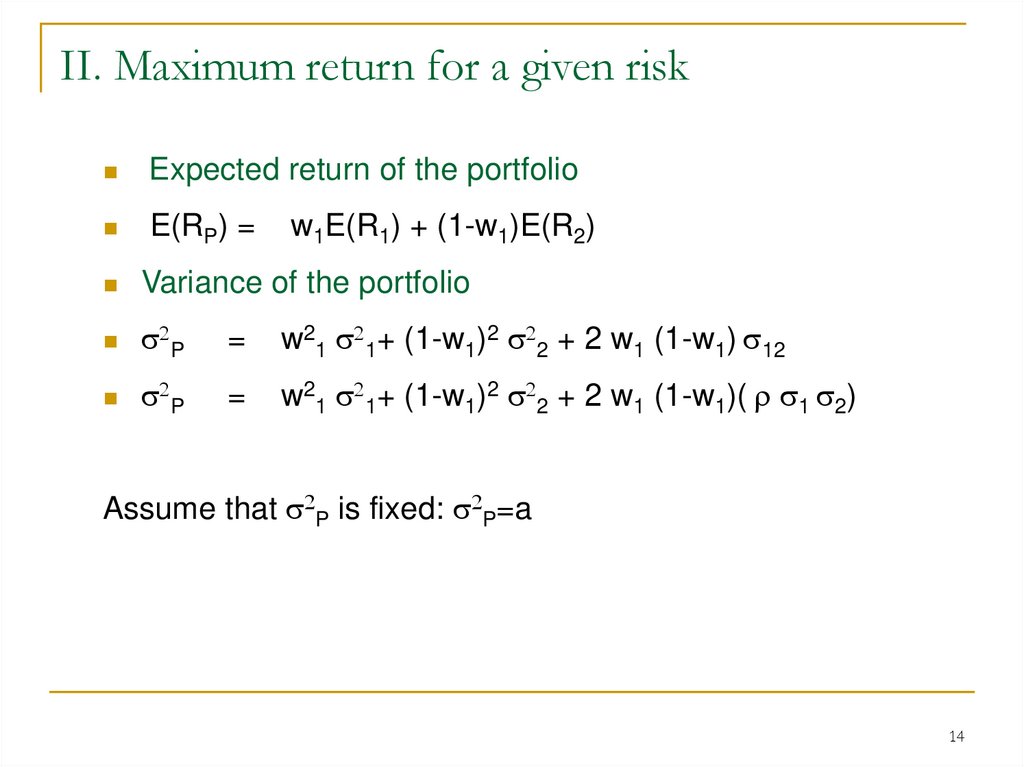

II. Maximum return for a given risk

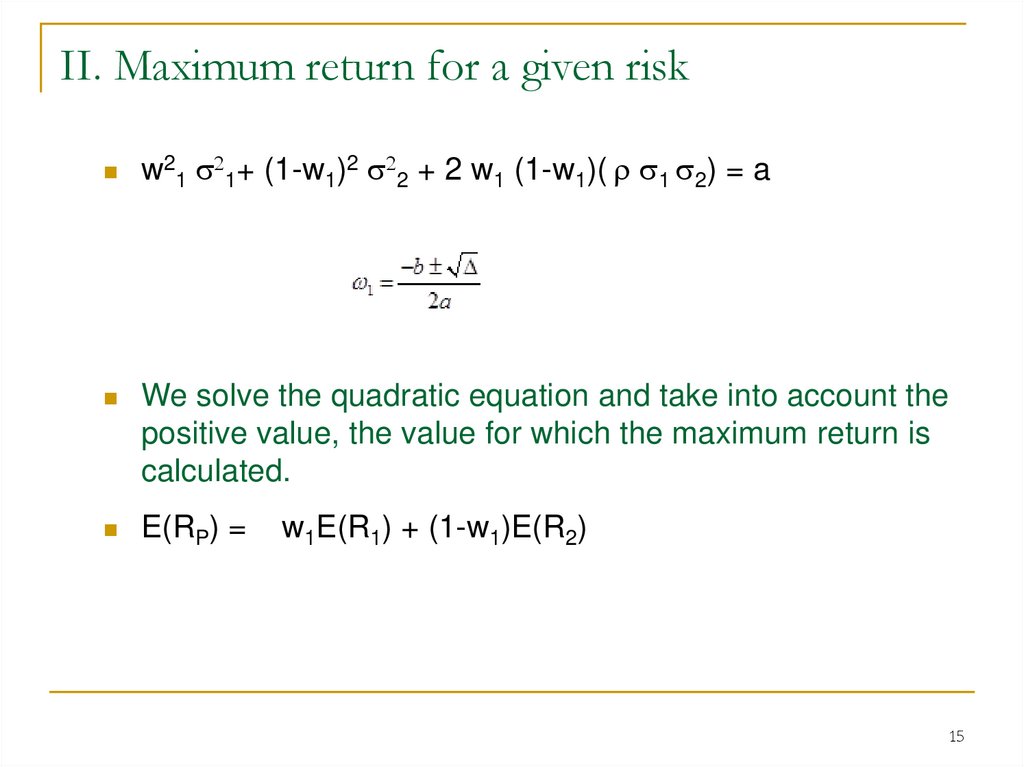

II. Maximum return for a given risk

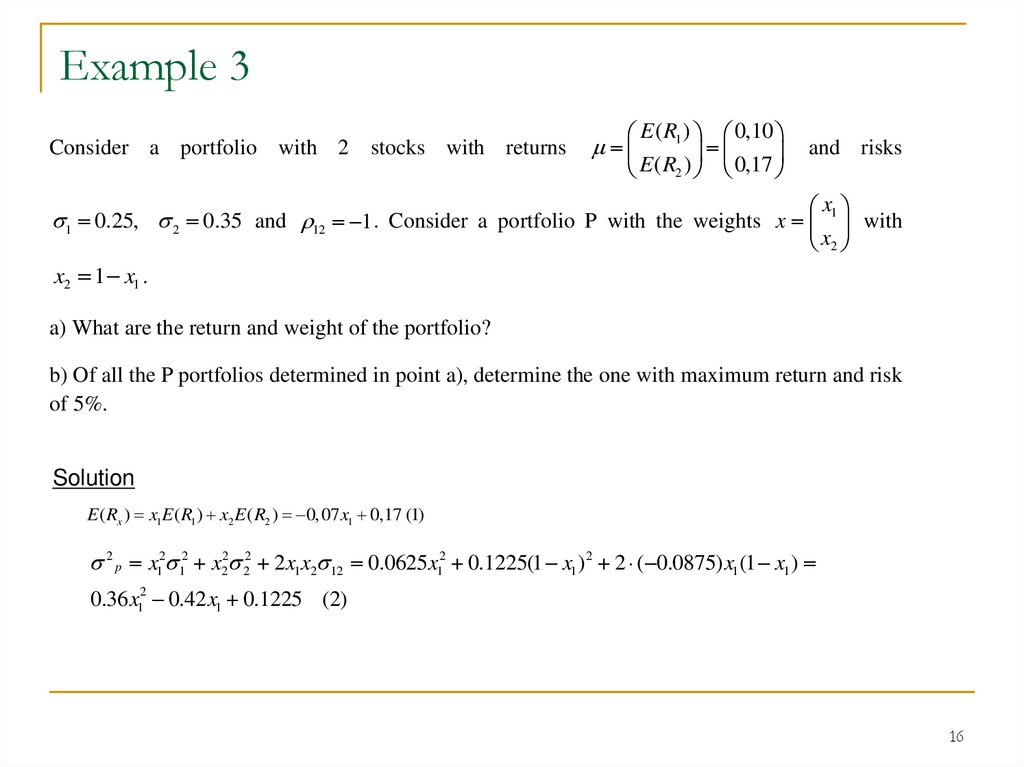

Example 3

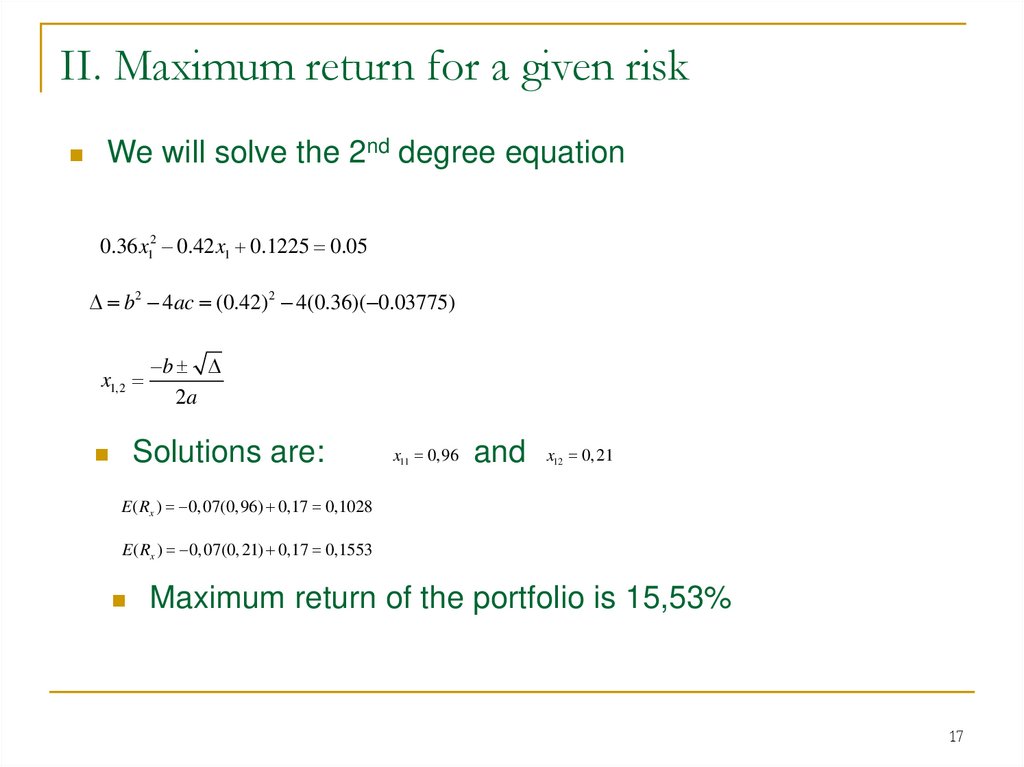

II. Maximum return for a given risk

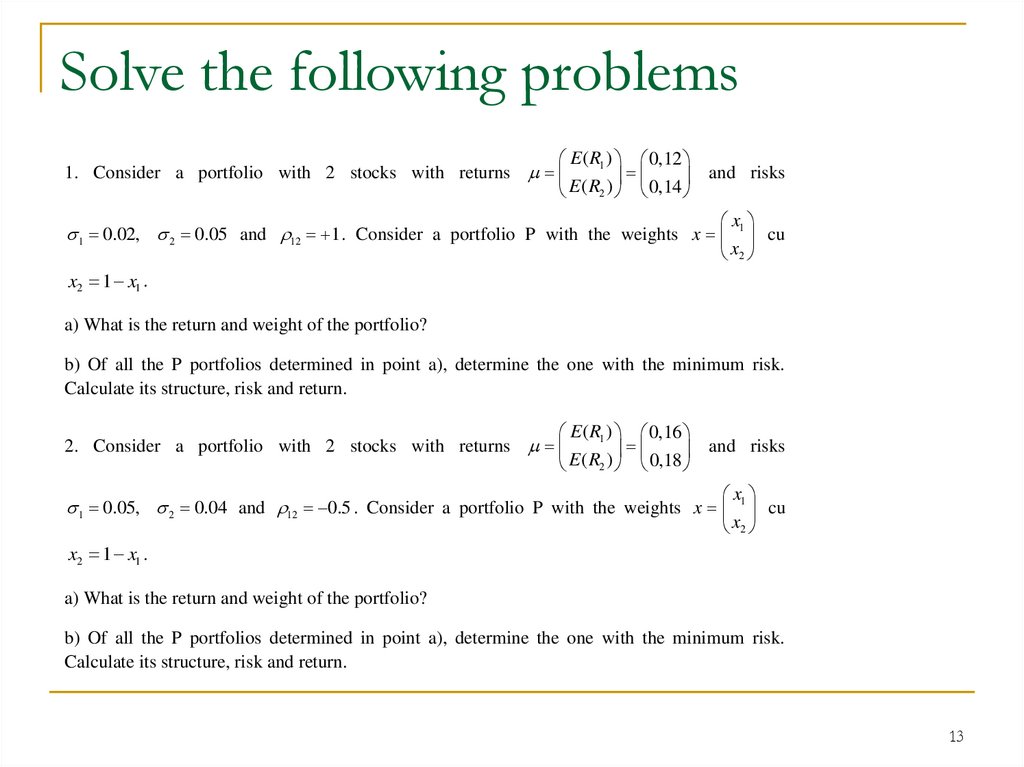

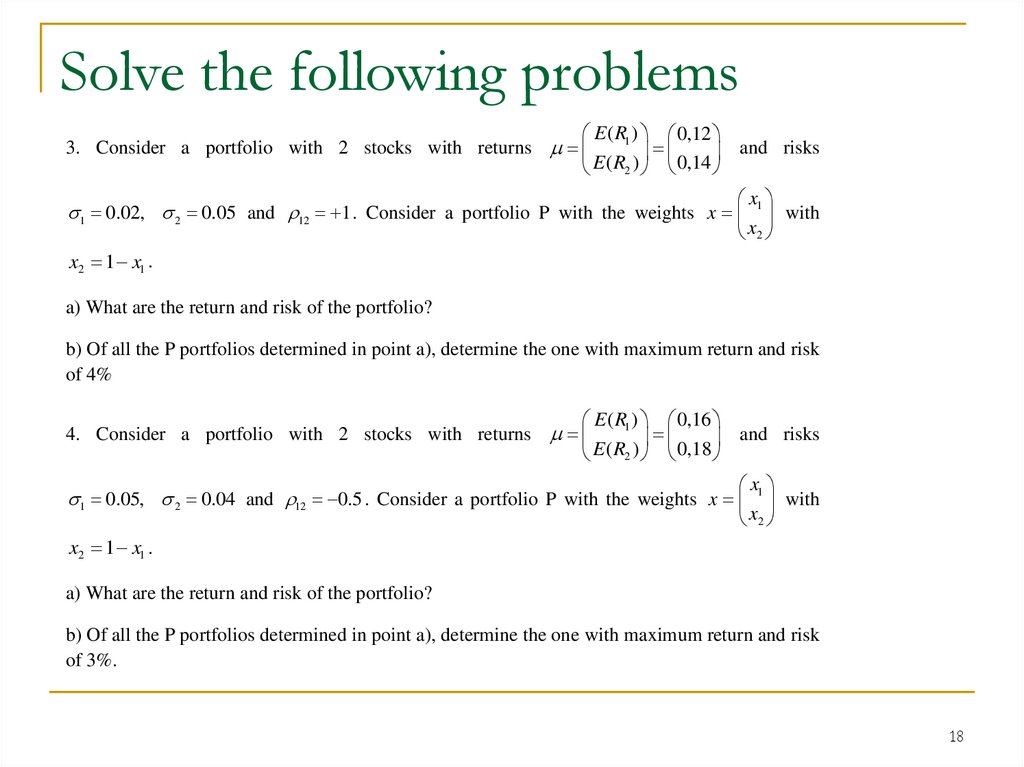

Solve the following problems
Q/A
206.38K
Category: financefinance

Measures of Risk and Uncertainty Efficient portfolios consisting of two risky assets

1. Measures of Risk and Uncertainty

Efficient portfolios consisting of two
risky assets

2. Course Outline

1. Quantitative methods in decision making: goals, potentials and limits
(1C)
2. Data collection and presentation (1C)
3. Use of descriptive statistics for describing the features of the data
(2C)
4. The role of financial mathematics in business decisions mathematical methods (2C)
5. Valuation of financial instruments and business decisions (2C)
Preparation for the inter-mediate assignment (1C)
6. Measures of risk and uncertainty (2C)
7. Statistical inference in business. Business planning on the basis of
predictions and assumptions. (3C)
8. Correlation and regression analysis for decision making (3C)
2

3. Grading

Quantitative Business Decision
Grading
20 points – Mid-term Exam
40 points – Final Exam
10 extra points – In-class performance
Seminars – EXCEL and SPSS

4. 2-stock Portfolio

For a portfolio of 2 shares, what are the
weights chosen so that:
I. Minimum risk for a fixed return.
II. Maximum return for a fixed risk.
4

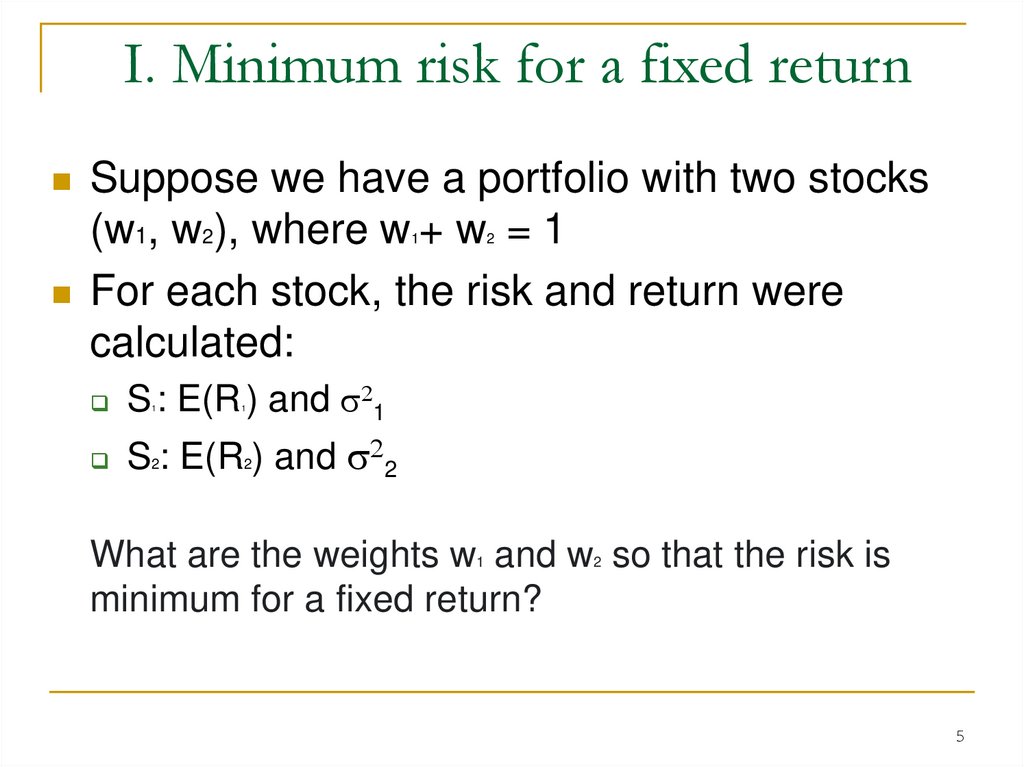

5. I. Minimum risk for a fixed return

Suppose we have a portfolio with two stocks
(w1, w2), where w + w = 1
For each stock, the risk and return were
calculated:
1
S : E(R ) and s21
S : E(R ) and s22
1
2
2
1
2
What are the weights w and w so that the risk is
minimum for a fixed return?
1
2
5

6. Definitions & formulas

Definitions & formulas
The expected return of a portfolio
E(RP) =
The variance of the portfolio
s2P
=
w21 s21+ w22 s22 + 2 w1 w2 s12
s2P
=
w21 s21+ w22 s22 + 2 w1 w2( s1 s2)
Thus, the weights are: w1 + w2 = 1.
Obs. s12 = 12 s1 s2 - formula
w1E(R1) + w2 E(R2)
6

7. I. Maximum return for a fixed risk

Expected return
E(RP) = w1E(R1) + (1-w1)E(R2)
Variance
s2P
=
w21 s21+ (1-w1)2 s22 + 2 w1 (1-w1) s12
s2P
=
w21 s21+ (1-w1)2 s22 + 2 w1 (1-w1)( s1 s2)
s2P is minimum when:
